House Renovation Cost Ireland 2026 Budgets Explained

House renovation cost Ireland guide with per m² rates by tier, cost drivers, hidden costs, SEAI grants and quoting tips to budget your whole-house refurb.

14 min read
House Renovation Cost Ireland 2026 Budgets Explained

A whole-house renovation in Ireland commonly falls into three broad bands: €800–€1,200 per m² for a cosmetic refresh, €1,200–€2,000 per m² for a standard renovation, and €2,700–€3,300 per m² for full structural work. For a 110 m² three-bed semi-detached house, the standard band gives a base construction budget of roughly €132,000–€220,000 before VAT, professional fees, surveys and contingency.

That is why the phrase house renovation cost Ireland needs more than one headline average. A house needing paint, flooring and minor joinery isn't financially comparable with an older property requiring a strip-out, rewiring, replumbing, insulation, heating replacement and structural alterations. The reliable starting point is the floor area multiplied by a scope-based Irish rate, followed by a written schedule of what the quote includes.

Find renovation contractors and post your job once the scope and budget are sufficiently clear. The figures below are planning ranges, not a substitute for a survey and itemised quotation.

How Much Whole House Renovation Costs in Ireland Right Now

A useful Irish starting point is the floor area multiplied by a scope-based rate. The Society of Chartered Surveyors Ireland Real Cost of Renovation study uses case studies of 20 vacant and derelict properties across the country, showing why condition and scope matter more than one national average (SCSI renovation benchmark). A light refurbishment may retain most services. A deep refurbishment can require floors, walls and ceilings to be opened throughout.

For a 110 m² three-bed semi, the standard band works out as:

  • 110 m² × €1,200 per m² = €132,000
  • 110 m² × €2,000 per m² = €220,000

These figures are a mid-range base construction budget before VAT, professional fees, surveys and contingency, on aggregate Irish market estimates. They are not a turnkey total. Scaffolding, restricted access, waste removal, design, engineering, certification, temporary accommodation and making good may all sit outside the headline rate.

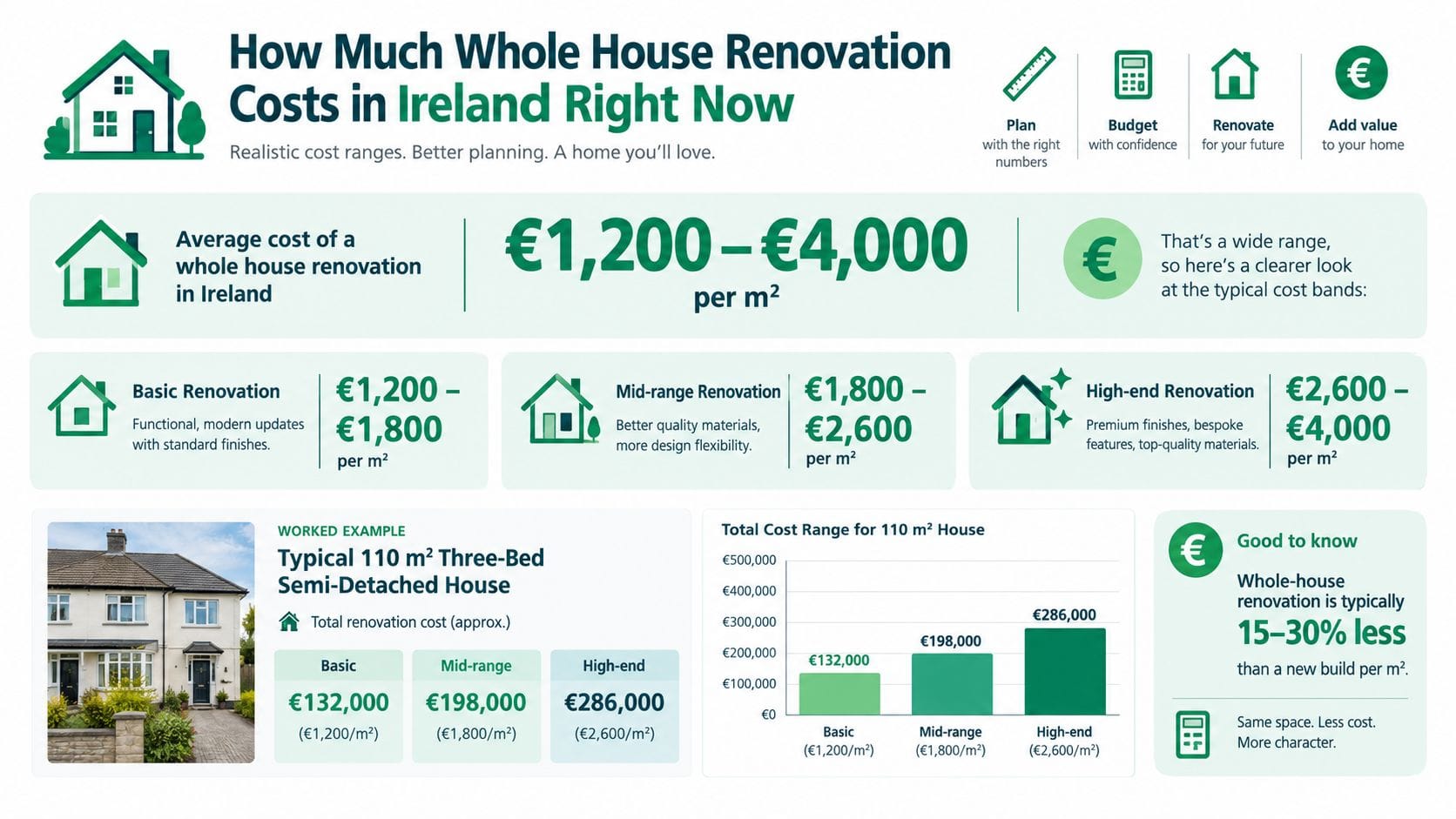

An infographic showing average whole house renovation costs per square meter in Ireland for different levels.

What a whole-house renovation usually includes

An end-to-end refurbishment can cover:

  • Preliminaries and strip-out, including old fixtures, finishes and redundant services.
  • Structural work, such as altered openings, floor repairs, steelwork or layout changes.
  • Mechanical and electrical services, including rewiring, replumbing, heating, ventilation and controls.
  • Thermal improvements, including insulation, airtightness measures, window replacement and energy-system upgrades.
  • Interior completion, covering the kitchen, bathrooms, plastering, flooring, internal doors, joinery, painting and decorating.
  • Making good, testing, certification and final connections.

A kitchen or bathroom replacement is narrower and should be priced as a separate package. Rebuilding a house is a different comparison. Irish construction-sector rebuilding data places the minimum base rebuilding cost of a 98 m² three-bed semi in Dublin at €331,340, or €3,381 per m², after a 7% national rise in rebuilding costs. That context shows why extensive structural, mechanical and electrical work can move renovation economics towards rebuilding costs.

Roof replacement can change the budget substantially, so keep that specialist package separate from the whole-house allowance and price it on its own.

Renovation Tiers by Scope and Price Per Square Metre

The main budget question is how much of the existing house will be disturbed. Retaining sound wiring, plumbing and heating keeps a project in a different category from stripping rooms back to masonry and renewing every service route. Finishes matter, but hidden mechanical and electrical work usually creates the larger jump.

The table uses Irish per-square-metre planning bands. The example totals apply the rates to 110 m², before VAT, professional fees and contingency.

Whole House Renovation Cost by Tier in Ireland

Renovation Tier Typical Scope Included Cost Per m² ex VAT Indicative Total for 110 m²
Cosmetic refresh Painting, decorating, flooring, minor carpentry, lighting changes and local repairs, with most wiring, plumbing and heating retained €800–€1,200 per m² €88,000–€132,000
Standard renovation Kitchen and bathroom renewal, selected layout changes, rewire or significant electrical work, plumbing alterations, insulation improvements, plastering, flooring and finishes €1,200–€2,000 per m² €132,000–€220,000
Full gut or deep refurbishment Extensive strip-out, structural changes, full replumb and rewire, heating replacement, major insulation and window work, plastering, joinery and complete internal finishes €2,700–€3,300 per m² €297,000–€363,000

These bands are planning tools, not fixed industry classifications. An Irish pricing guide gives lower overlapping ranges for light refurbishment, mid-range work, full renovation and major deep-retrofit or period-property projects, from €450–€800 per m² through to €2,100–€3,000+ per m² (Solarinfo Irish renovation guidance). The overlap reflects scope: two projects with the same floor area may require very different levels of strip-out, service replacement and energy work.

Why the middle tier can become a full refurbishment

A house can look suitable for a standard renovation until walls and floors are opened. Replacing the electrical installation, plumbing routes, insulation and heating system adds first-fix labour, access work, coordination and reinstatement. Energy upgrades can also include windows and ventilation, so the cost increase is often driven by the building's infrastructure rather than paint, flooring or kitchen style.

The distinction is similar to servicing a car versus rebuilding its systems. A cosmetic project changes what is visible. A deep refurbishment changes what makes the house operate.

Regional pricing also affects the starting band. Dublin commonly costs more than rural areas, while Irish guidance indicates a regional spread of roughly ±35% for some renovation work. Use the table to set an initial allowance, then obtain local quotes that reflect the address, access, existing condition and required M&E upgrades.

What Drives the Final Renovation Budget Up or Down

Two houses with the same floor area can have very different renovation bills. Floor area measures scale, but it does not describe condition. A sound house with serviceable wiring may stay within a lower per m² band. An older property with damp, failed services or structural movement may require a much deeper intervention.

A clear infographic for a house renovation budget section in Ireland, showing the main cost drivers for a whole-house re

Seven decisions that move the figure

  1. Extent of renovation. A cosmetic refresh limits demolition and first-fix work. A full gut adds strip-out, waste disposal, replacement services and extensive reinstatement. The large cost jump usually comes from hidden mechanical and electrical work, not from choosing a better paint or floor finish.

  2. House size. A quoted rate per m² produces a higher total as the treated floor area grows. The rate still needs checking. A small house with complex structural work can cost more per m² than a larger, straightforward property.

  3. Age and condition. Older housing stock may contain damp, timber decay, uneven floors, outdated wiring and plumbing that was not designed for the proposed layout. A survey helps identify these risks before the contract sum is fixed.

  4. Structural changes. Removing walls, changing openings, altering stairs or repairing foundations brings design, engineering, temporary works and compliance requirements. For wider construction work, find tradespeople and post a task when the project includes an extension, major structural alteration or a comparison with building new.

  5. Heating and energy upgrades. Insulation, airtightness, ventilation, heat-pump installation and controls must work as one system. A deep retrofit therefore depends on the home's starting condition and can add substantial first-fix and coordination work, rather than improving individual rooms.

  6. Kitchen and bathroom specification. Cabinet construction, worktops, appliances, sanitaryware, ventilation, tiling and plumbing positions all affect the allowance. Two rooms with a similar appearance can require very different installation work.

  7. Finishes and joinery. Internal doors, skirting, wardrobes, stairs, flooring and decorative finishes can move a project within its tier. Changes after ordering create rework, storage and replacement costs.

Labour is generally the largest budget component, followed by materials. Professional fees and permits usually form a smaller share, but their allowances still need to be included. Dublin labour rates are generally higher than rural rates, so written local quotations matter more than a national average.

Price a separate plastering allowance for that trade rather than treating plastering as the whole renovation budget.

Hidden Costs That Often Appear Once Work Starts

Strip-out changes the quality of information available to the surveyor and contractor. A wall may conceal defective wiring, a floor may conceal rot, and an apparently minor damp mark may point to a wider moisture problem. The budget risk comes from unknown condition, not from the act of opening a wall itself.

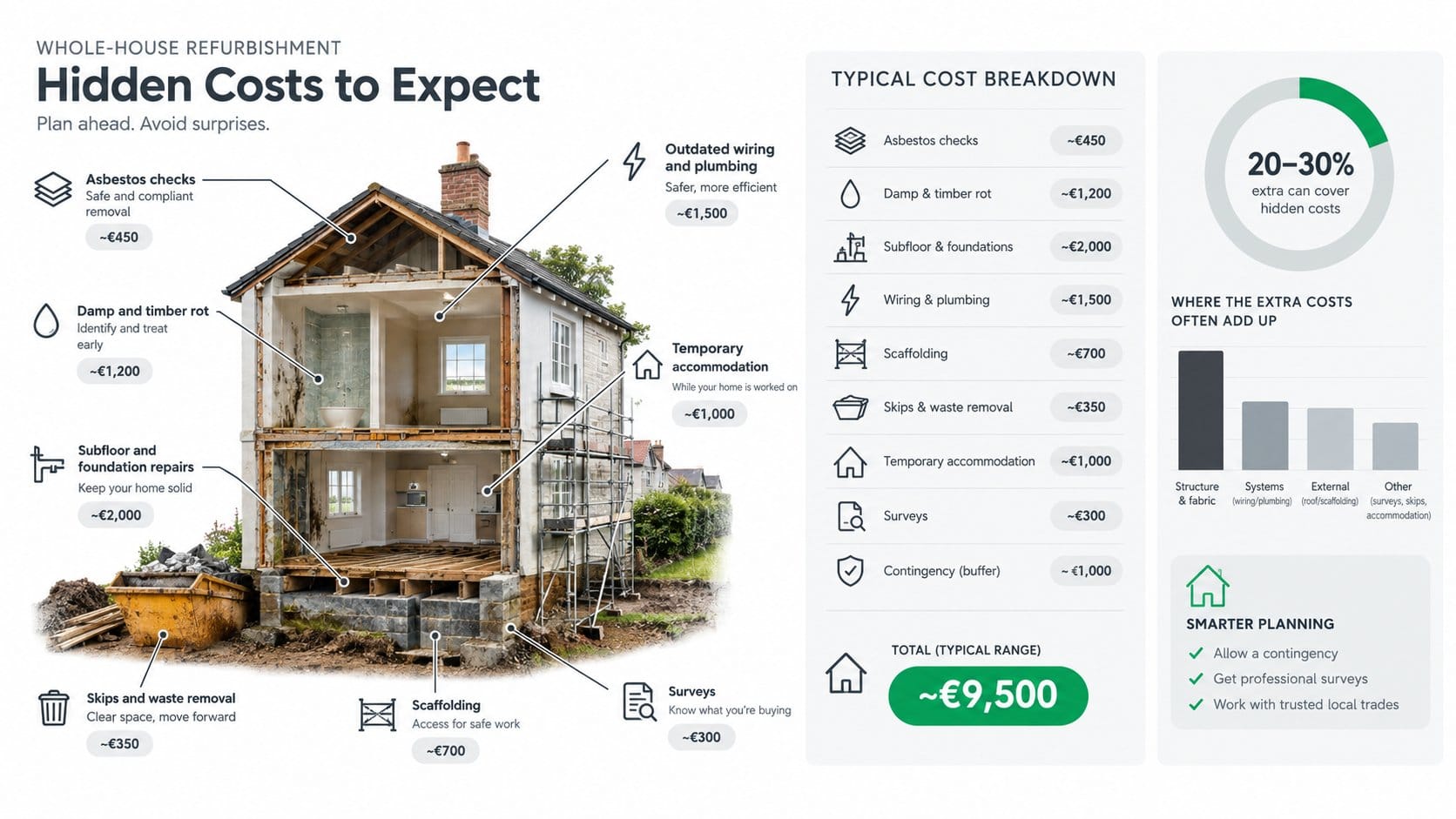

An infographic for a home renovation article in Ireland showing common hidden costs in a whole-house refurbishment, incl

Conditions that deserve early investigation

  • Asbestos-containing materials. Homes built before 2000 may contain asbestos in materials such as insulation products, boards, adhesives or older finishes. Testing and removal should be handled safely by appropriately qualified specialists, rather than folded into ordinary demolition.

  • Damp and timber rot. Water ingress, defective gutters, bridged external levels, leaking services and poor ventilation can affect floors, joists, roof timbers and internal finishes. The visible repair may be smaller than the work needed to remove the source.

  • Foundations and subfloors. Cracking, settlement, suspended timber floors and damaged slabs can require specialist investigation. A floor-level change can then affect doors, stairs, kitchen units and service routes.

  • Old electrical and plumbing systems. A partial allowance may become a full replacement when the existing installation can't safely support the new layout or current equipment.

  • Regulatory and compliance work. Alterations may require design input, documentation, inspection or certification. The correct route depends on the proposed work and property.

Items frequently left outside a headline rate

A quote can exclude scaffolding, restricted access, waste removal, skips, protection, temporary works, preparation, final connections and making good. Temporary accommodation and storage can also affect the household budget, especially where the property can't remain occupied.

Surveys should be commissioned before a fixed scope is agreed where the age or condition makes hidden defects plausible. A written quote should then identify provisional sums and explain what happens if an opening-up investigation reveals a defect.

Practical rule: a low headline price isn't comparable with another quote until both documents show the same demolition, access, waste, preparation, services and finishing obligations.

Grants and VAT Rules That Affect Your Renovation Budget

Grants usually fund specific eligible energy measures, rather than every part of a whole-house refurbishment. SEAI support may reduce the cost of insulation, heat pumps, windows and ventilation within a deep-retrofit package, subject to the scheme rules and application process.

A retrofit package is only one layer of the budget. Gross costs commonly sit around €50,000–€75,000, with more complex homes above €75,000. After SEAI-backed support, homeowner exposure is described at roughly €25,000–€48,000, depending on the building envelope, floor area and selected measures, on aggregate Irish market estimates. These figures cover energy upgrades and related works, not a new kitchen, structural alterations or full decorative refurbishment.

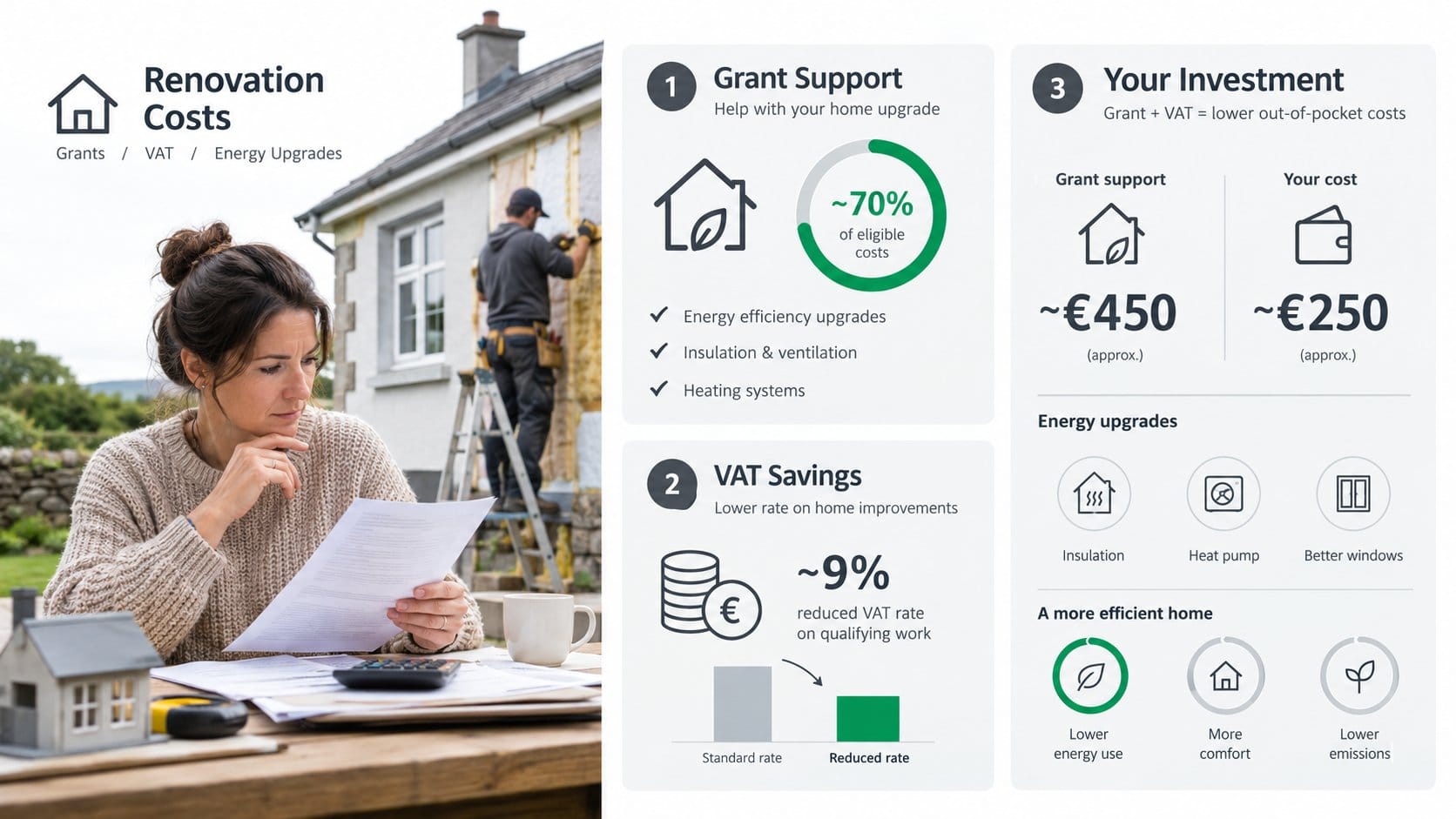

An infographic for a house renovation budget section in Ireland focused on grants and VAT, showing a homeowner reviewing

Vacant and derelict homes

The Vacant Property Refurbishment Grant can provide up to €50,000 for a vacant home and up to €70,000 for a derelict home in the Republic of Ireland. The approved amount includes VAT on eligible works, as outlined in the Citizens Information grant guidance.

Check eligibility, evidence and approval requirements before starting work. Treat the grant as a possible contribution, not as an automatic reduction in the contractor's price. Confirm which items qualify, when payment is made and which costs remain the homeowner's responsibility.

VAT on residential renovation

Residential renovation, repair and construction services generally use Ireland's reduced 13.5% VAT rate. It may apply to labour and materials under a qualifying supply-and-fit arrangement, including the two-thirds rule. The quote should state the VAT treatment for each relevant item; Revenue sets the applicable rates.

Ask whether every line is VAT-inclusive. Supply-only goods, specialist subcontractors, scaffolding and professional services may be treated separately. The Irish contract and the actual work supplied determine the VAT treatment.

How to Compare Quotes and Budget With Confidence

A reliable quote makes scope comparable before price enters the discussion. Give each contractor the same drawings, measured floor area, room schedule, specification, access details and list of energy upgrades. The resulting totals should also be tested against the relevant Irish per m² renovation band and the property's rebuild-cost context. A low figure may leave more work outside the quote.

Build a like-for-like comparison

Ask every contractor to state clearly whether the price includes:

  • Demolition and disposal, including fixture removal, protection of retained areas and waste charges.
  • Structural work, with engineering assumptions, temporary support and making good identified.
  • Services, separated into electrical, plumbing, heating, ventilation and controls. These systems often explain a larger cost jump than visible finishes.
  • Materials and finishes, including brands, grades, quantities, appliances, sanitaryware, flooring and paint systems.
  • Exclusions and provisional sums, so allowances are not read as fixed prices.
  • VAT and fees, including whether the total includes 13.5% VAT and whether surveys, design, certification and inspections are separate.

A kitchen appliance, window package or radiator can sit outside one quote and inside another. Compare both on the same basis, including light fittings, floor preparation and final decorating. Provisional sums need particular care because the final cost depends on what is found or selected later.

Protect the working budget

Keep the contingency separate from the agreed contract sum. It covers defects and scope changes, rather than upgrades chosen after work begins. Irish renovation guidance commonly recommends allowing 10–15% for unexpected costs, while older or less certain properties may require a more cautious allowance.

Payment stages should match identifiable progress, and every variation should be written down before the extra work starts. Check gas work through the Registered Gas Installers register and electrical work through Safe Electric. For roofing, general building, gardening and cleaning, request insurance details, a precise scope and genuine references and reviews, because these trades are not generally regulated in Ireland.

Extensions and major structural alterations need suitable design and compliance advice before accepting a general renovation quote. Finding providers can help, but it cannot replace a property-specific assessment.

Planning Your Next Steps to Hire Local Trades

Start by choosing the renovation tier that best matches the actual scope, then multiply the relevant Irish rate by the measured floor area. The resulting figure should be tested against a survey, an itemised schedule, the VAT position, professional fees and a contingency before the homeowner commits to finishes or a start date.

The next practical step is a written brief. It should list every room, retained item, replacement service, energy upgrade, structural alteration and exclusion. Separate specialist quotations may be appropriate for surveys, structural design, electrical work, plumbing, heating, windows, kitchen supply, plastering, flooring and decoration. Getting a separate plumbing quote is relevant where plumbing forms part of a wider programme, and the same principle applies to every trade.

Painting and decorating often comes after the disruptive work, so the scope should state preparation, protection, number of coats, colour changes and making good. Ask every provider for the same written finish specification.

A homeowner can also review how ShamFix connects Irish homeowners with local providers when looking for a marketplace option alongside direct referrals and professional recommendations. Providers describe their own credentials, customers check regulated registrations themselves, and routing an enquiry isn't a quality guarantee.

Posting the renovation project on ShamFix lets you describe the job and reach local providers, so you can take the next step with a clearer scope and budget.
